Case Study

Case Study: Solar installation at a Gorton petrol station

Project Overview

Building Type: Petrol Station with forecourt, garage, car wash, tyre bay and MOT station

Operating Hours: 7 days a week 24 hours a day

Current Electricity Usage: 131,000 kWh per annum

Current Unit Price: 35p per kWh

Forecast Annual Spend: £78,311.00

Recommended System: 76.5KWp with Solar Edge Rapid Shutdown, Firefighter Gateway and Optimisation.

Installation Dates: Dec 1st - Dec 7th, Commissioned on December 9th 2024

Audit

We strive to understand the requirements of our clients and carry out site surveys prior to every solar energy installation.

Design

Create a solution for a solar design backed up with specification data sheets.

Install

Arrange a install with a highly experienced and qualified install team.

Maintenance

Arrange a maintenance agreement if required.

The Location

Gorton Street Petrol Station is a petrol forecourt incorporating a garage, MOT Centre, Tyre Bay and Car wash in the UK.

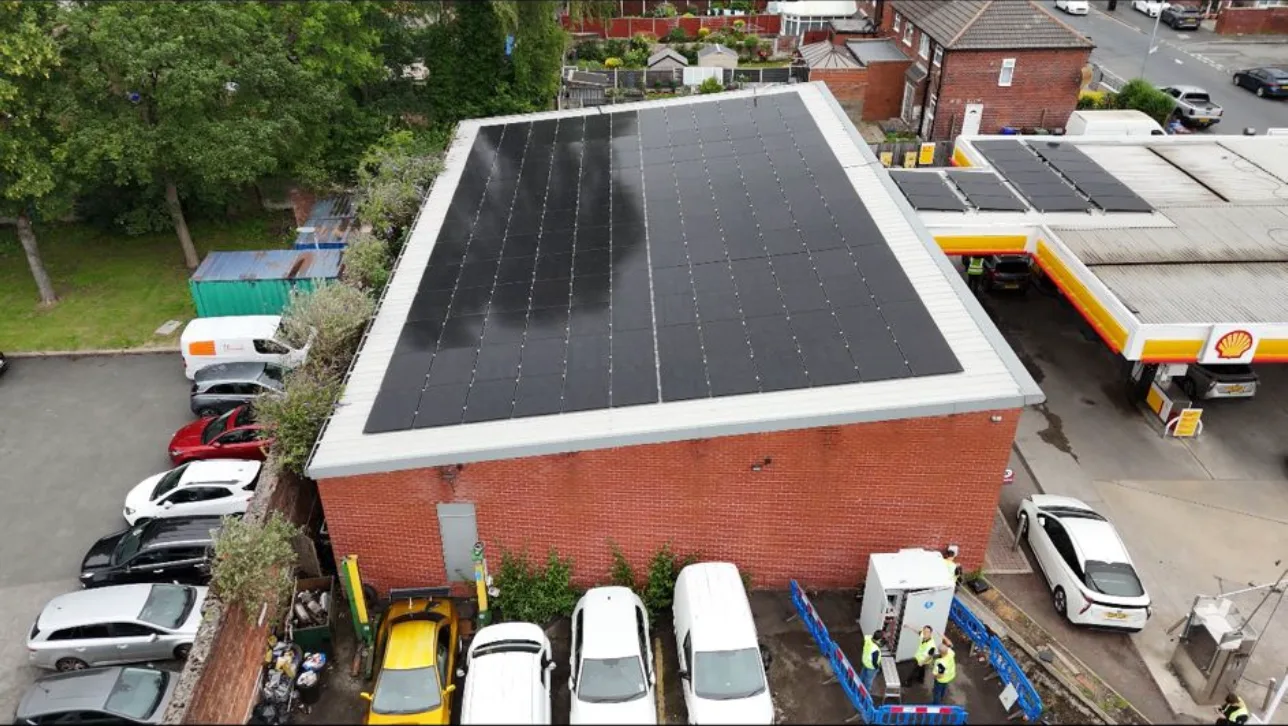

An completed solar panel installation at a garage in Gorton UK

An effective solar panel installation at a busy petrol station and garage in Gorton UK.

The Brief

To utilise the shop roof and canopy roof to install Solar PV and significantly reduce the current annual cost of electricity.

Challenges

The Petrol Station operates 7 days a week 24 hours a day and is very busy.

Current Electricity Usage

Current electricity usage 131,000 kw pa.
Forecast annual spend £78,311.00

The Solution

Recommended system 76.5KWp with Solar Edge Rapid Shutdown, Firefighter Gateway and Optimisation.
Solar Edge Rapid Shutdown was recommended as an additional safeguard to reduce the risk of fire on petrol forecourts.
Some insurance companies specify Rapid Shutdown Technology as a pre-requisite for insuring Solar PV.

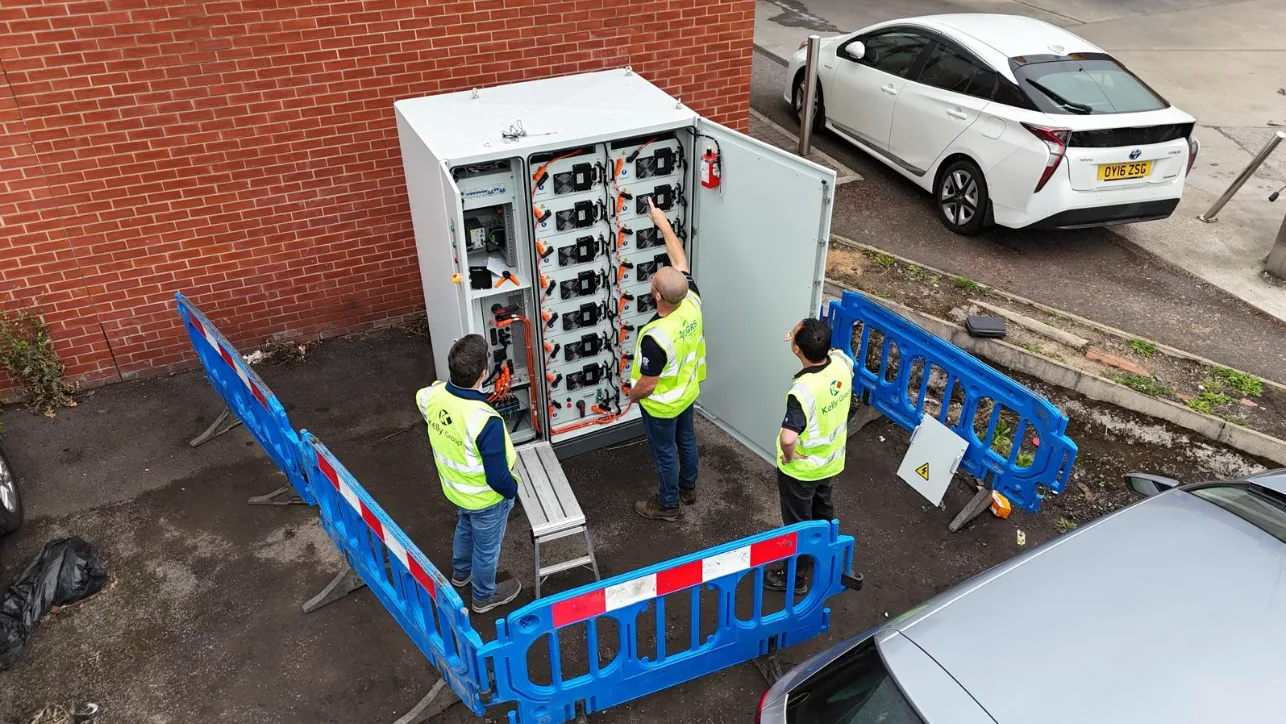

Installation of a state of the art commercial solar system

A state of the art solar system installation cage being fitted to a petrol station in Gorton UK.

Installation

To avoid disruption to a busy petrol forecourt scaffolding was installed at 5.00am and installation was completed before the forecourt opened.
Installation commenced at the beginning of December 2024
Installation was completed by December 7th. 2024
System commissioned on December 9th. 2024

Energy Cost Savings

The system will generate generate year 1 - 67,733 kw of electricity pa.67,733 KW.
Savings year 1 £ 16 309,00
Payback 2 years 10 months.
Further Benefits Gorton Street Station – going forward
Additional savings will be achieved by eliminating capacity charges and surcharges which contribute to excess charges incurred on the clients bill.
Differential rates between night time and daytime rates will be kept under constant review.

Why Choose Us for Your Solar Solutions?

Our comprehensive approach to solar installations ensures each project is tailored to meet specific client needs. From initial consultation and design to installation and performance monitoring, our team of experts is dedicated to delivering exceptional results.

Contact us today to learn how we can help future-proof your business with sustainable solar energy solutions.

Loading...
